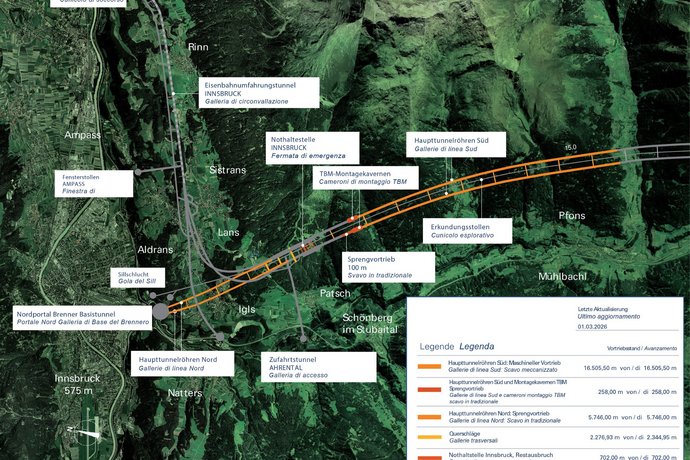

Tunnel tubes will be excavated in this construction lot
In total, approx. 22.5 km of main tunnel tubes will be excavated
Connecting tunnels to be constructed between the two main tubes
Tunnel boring machines of this construction lot: IDA and LILIA
Executive construction consortium: ARGE H41 Sill Gorge-Pfons consortium, consisting of Implenia Österreich GmbH, Implenia Schweiz AG, Webuild S.p.A, csc costruzioni sa
Contract value: 651 million EUR
Both tunnelling methods are being used in this construction lot: The main east and west tunnels northwards (towards Innsbruck) were constructed using traditional mining methods, i.e. blasting, while the two main tunnels southwards were constructed using machines, i.e. tunnel boring machines (TBMs).
Mechanical excavation began in 2023. On May 2nd, TBM Lilia set off on its 8,108 m journey in the main east tunnel. On June 27th, TBM Ida was started up in the main west tunnel. Both tunnel boring machines reached their destination in the second half of 2025.
NEW BRIDGE OVER THE A13 BRENNER MOTORWAY
Space is limited on the H41 construction site. In order to make optimum use of the available space and gain additional landfill space for the tunnel excavation material, the existing underpass to the A13 motorway exit towards Innsbruck was filled in and a prestressed concrete bridge was built over the motorway instead.
The possible construction times were specified by the motorway operator and were severely restricted by holiday periods and public holidays with high traffic volumes. Traffic restrictions were not permitted during these periods.
For the construction work, an assembly scaffold was erected above both lanes of the Brenner motorway; this work was carried out in 2023 over the space of 10 days during nightly total lane closures.
This allowed traffic to flow freely during the formwork and concreting work.
In the available construction period, which lasted only two months, the bridge structure was formed and concreted, and the assembly scaffolding was dismantled again. The bridge has been open to traffic and in operation since October 2023.
